Lift Station 5 Sanitary Sewer Forcemain Project

Stay up-to-date! Click here to receive email notifications.

The Lift Station 5 project is now complete, and the roadway is open to normal traffic patterns. The City of Arden Hills thanks the community for its patience over the past several weeks. This project represents an important investment in the City’s infrastructure. Although it often goes unseen, this system plays a vital role in maintaining a reliable and safe wastewater collection and treatment system.

Construction Update: November 14 - Project Complete

Crews completed the final paving of the Co Rd E patch at Lake Johanna Blvd, which allowed the removal of the lane restriction on Co Rd E. Turf and landscaping restoration were completed at Stowe Ave and Noble Rd. During the week of November 3, crews worked on turf restoration at both Stowe Ave and Noble Rd, and continued lift station work at the site located at Lake Johanna Blvd and Co Rd E.


Construction Update: November 5 - Project Nearing Completion

This week, crews will continue lift station restoration at the site located at Lake Johanna Blvd and Co Rd E, as well as ongoing turf restoration along Stowe Ave and Noble Rd.

During the week of October 27, the contractor completed road restoration and began turf restoration at both Stowe Ave and Noble Rd. Co Rd E was brought to a gravel surface, however, a detour is in place on Co Rd E sending commuters back through Stowe Ave intermittently as work is performed. Work continued at the lift station located at Co Rd E and Lake Johanna Blvd.

Construction Update: November 5 - Project Nearing Completion

This week, crews will continue lift station restoration at the site located at Lake Johanna Blvd and Co Rd E, as well as ongoing turf restoration along Stowe Ave and Noble Rd.

During the week of October 27, the contractor completed road restoration and began turf restoration at both Stowe Ave and Noble Rd. Co Rd E was brought to a gravel surface, however, a detour is in place on Co Rd E sending commuters back through Stowe Ave intermittently as work is performed. Work continued at the lift station located at Co Rd E and Lake Johanna Blvd.

Construction Update: October 29

Crews are completing road restoration and reopening all lanes at County Road E and Lake Johanna Boulevard. They are also finishing restoration work at Noble Road, as well as road and trail restoration along Stowe Avenue. Additionally, a section of roadway at Fairview Avenue and Noble Road is being excavated to allow for the filling of a retired sanitary sewer pipe.

Construction Update: October 22

This week, the contractor is continuing pipe and structure work at the Lift Station located at Co Rd E and Lake Johanna Blvd. Testing of the newly installed pipe is underway and crews are preparing for the final restoration of Co Rd E at Lake Johanna Blvd.

Construction Update: October 17

This week, the contractor completed localized work along Stowe Ave and reopened the roadway in gravel condition, with paving of the gravel area still planned for later this fall. Backfilling and restoration work were also completed at Noble Rd, which has since reopened. In addition, the contractor began work at the sanitary sewer lift station located at Co Rd E and Lake Johanna Blvd and implemented a lane closure on Co Rd E, with a detour available via Stowe Ave.

Construction Update: October 10

This week, local underground utility work continued along Stowe Ave. Backfilling and preparation for restoration work are ongoing at Noble Rd. A watermain shutdown occurred on Friday, Oct. 10, to allow for the installation of a new hydrant.

Construction Update: September 29

Construction at the intersection of Stowe Ave and Lake Johnanna Blvd will begin. Stowe Ave will close to thru traffic and Co Rd E will reopen to all traffic. Stowe Ave thru traffic will be directed to Co Rd E. Noble Rd will remain closed.

Construction Update: September 22

Contractors will complete the new sanitary sewer pipe between Noble Road and Co Rd E from Lake Johanna to the trail/power line easement. On September 29,  Stowe Ave at New Brighton Rd will close due to the installation of new sanitary sewer pipe between Stowe Ave and Noble Road under the power line/trail corridor.

Week of September 19

Contractors have completed drilling and reaming for the new forcemain along County Road E from Lake Johanna to the trail/power line easement. Installation of the forcemain in this section is anticipated to take place by the end of this week (September 19). During the week of September 22, crews will begin digging a pit on County Road E and will start the drilling process toward Noble Road.

Project Overview

The City of Arden Hills has gone through the bidding process and awarded New Look Contracting with a project to replace a sanitary sewer forcemain pipe between Lake Johanna Boulevard and County Road E, along power line/trail easement area. The map below illustrates the corridor where this project is planned. This sanitary sewer pipe is a key part of the City’s sewage management system that ensures that the City is able to ensure a reliable and safe wastewater collection and treatment system. This project has been planned for in the City’s Capital Improvement Plan project funding will not include special assessments to property owners.

Residents can expect to see surveyors, and contractor personnel and equipment, as well as private utilities such as Xcel Energy, in the area in the next couple of months and throughout the fall working on these tasks.

For the blue and green lines (installation of new sewer pipe), most of the work is expected to occur without excavation, but the areas highlighted with the yellow boxes are expected to be excavation areas and result in lane/road closures. Access to all properties are required to remain from at least one direction and closures on County Road E and Stowe Ave shall require posted detours. The red line indicates abandonment of the existing sewer pipe which will require very little disturbance to the surface.

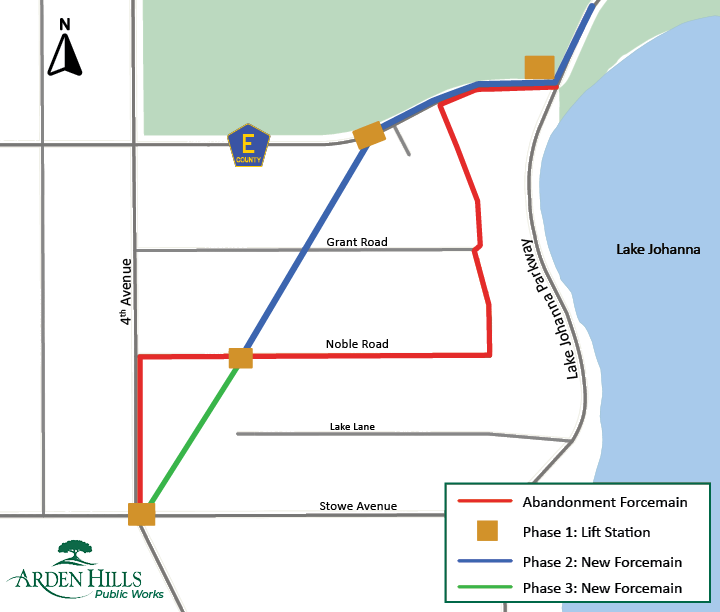

This webpage will be updated as the project progresses with milestones and rough timelines. The project is planned to be substantially completed this fall. Once again, there will be trail and roadway closures on this project. Please adhere to the detours and other signage on site when they are posted.Sewer Improvements Project Map-web

Project Contacts

Brandon Mensing, Site InspectorBolton & Menk612-289-0313brandon.mensing@bolton-menk.com
Ryan Peterson, Engineering and Inspection TeamBolton & Menk612-297-9518ryan.peterson@bolton-menk.com
Lucas Miller, Assistant Public Works DirectorCity of Arden Hills651-792-7846lmiller@cityofardenhills.org
Jeff Frid, Public Works SuperintendentCity of Arden Hills651-762-7852jfrid@cityofardenhills.org
